The most cost-effective way to install your Eco Structure is by following our detailed instructions and building it yourself. Our process not only empowers you to create unique travel experiences but also ensures exceptional profit margins and high returns on investment. We’re committed to adding value at every step, assuring you that you’re investing in the highest quality, longest-lasting glamping products available today.
Option 1 | The most cost-effective way to install your Eco Structure is to follow our detailed instructions and build yourself. |
Option 2 | We can put you in contact with local installers who can erect the structures in accordance with our instructions. We have a list of preferred installers that we’d be happy to share with you and provide a turn-key price for this solution. |
Option 3 | We have experience trainers who can assist you with the installation process as a reasonable cost. |

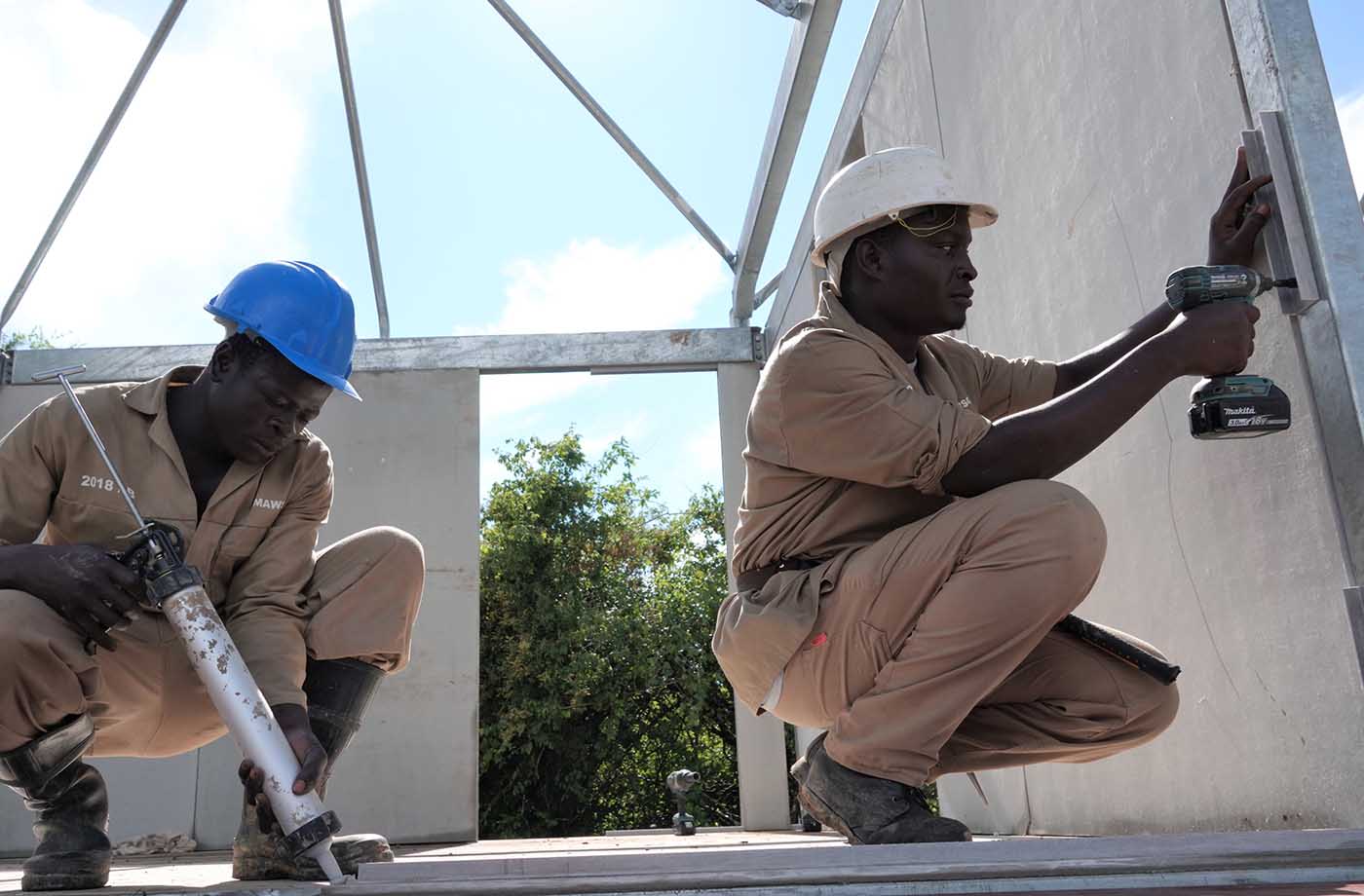

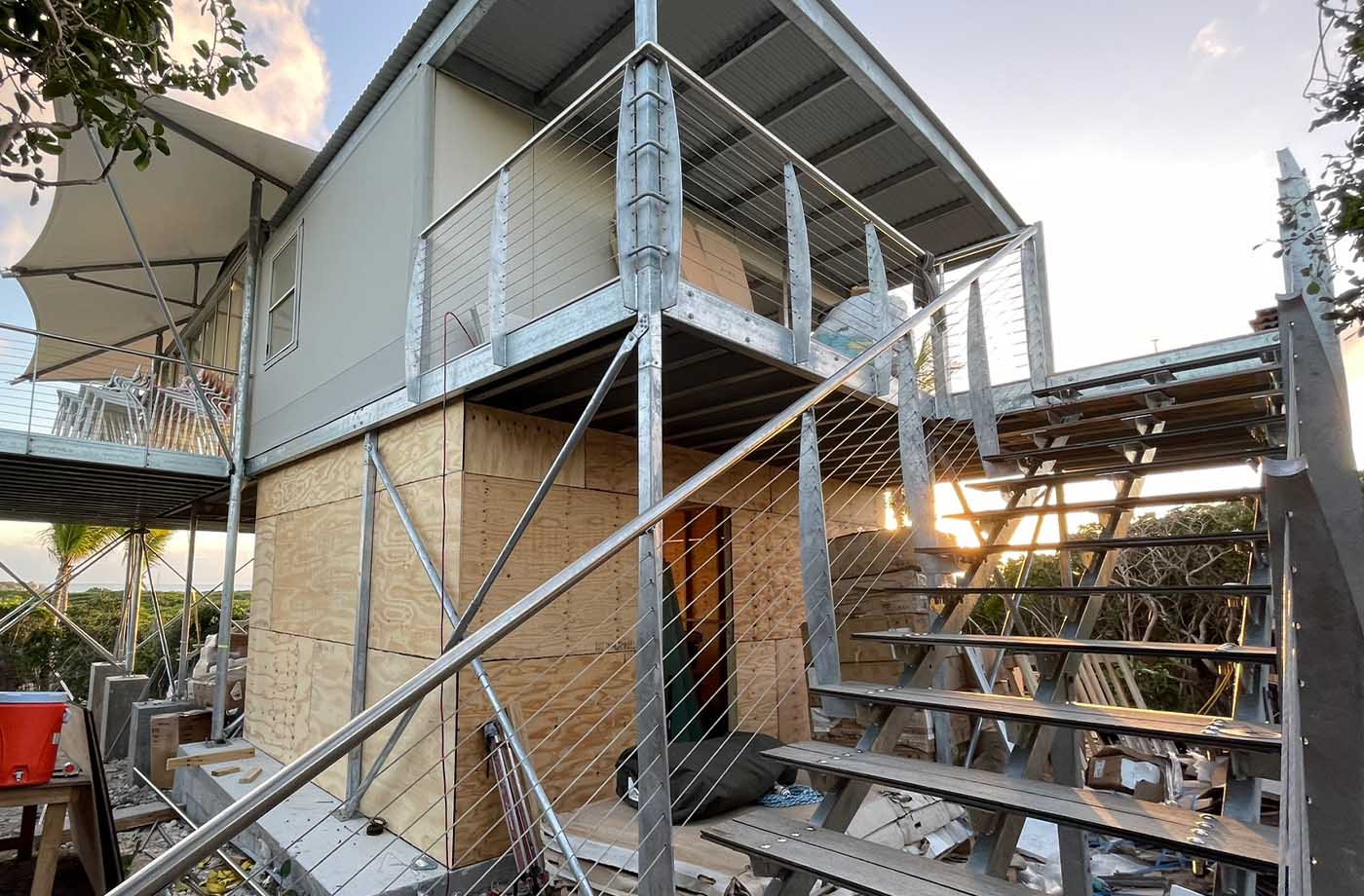

Option 4 | Where necessary, we can come to site and provide full supervision of the installation process and project manage the complete entire install. In this case we will manage the installation of the Eco Structures only, everything else is under your control. |
Option 5 | If required we can manage a complete build, including all services and installation. In this case, we’d deal with all contractors. This is approximately 15% more. |
Site Preparation
Please ensure the project site is cleared and free of obstacles.
The site should be level within 100mm.
Confirm that the ground is appropriate for eco anchor installation.
Provide necessary heavy machinery, such as a crane, bobcat, or telehandler.

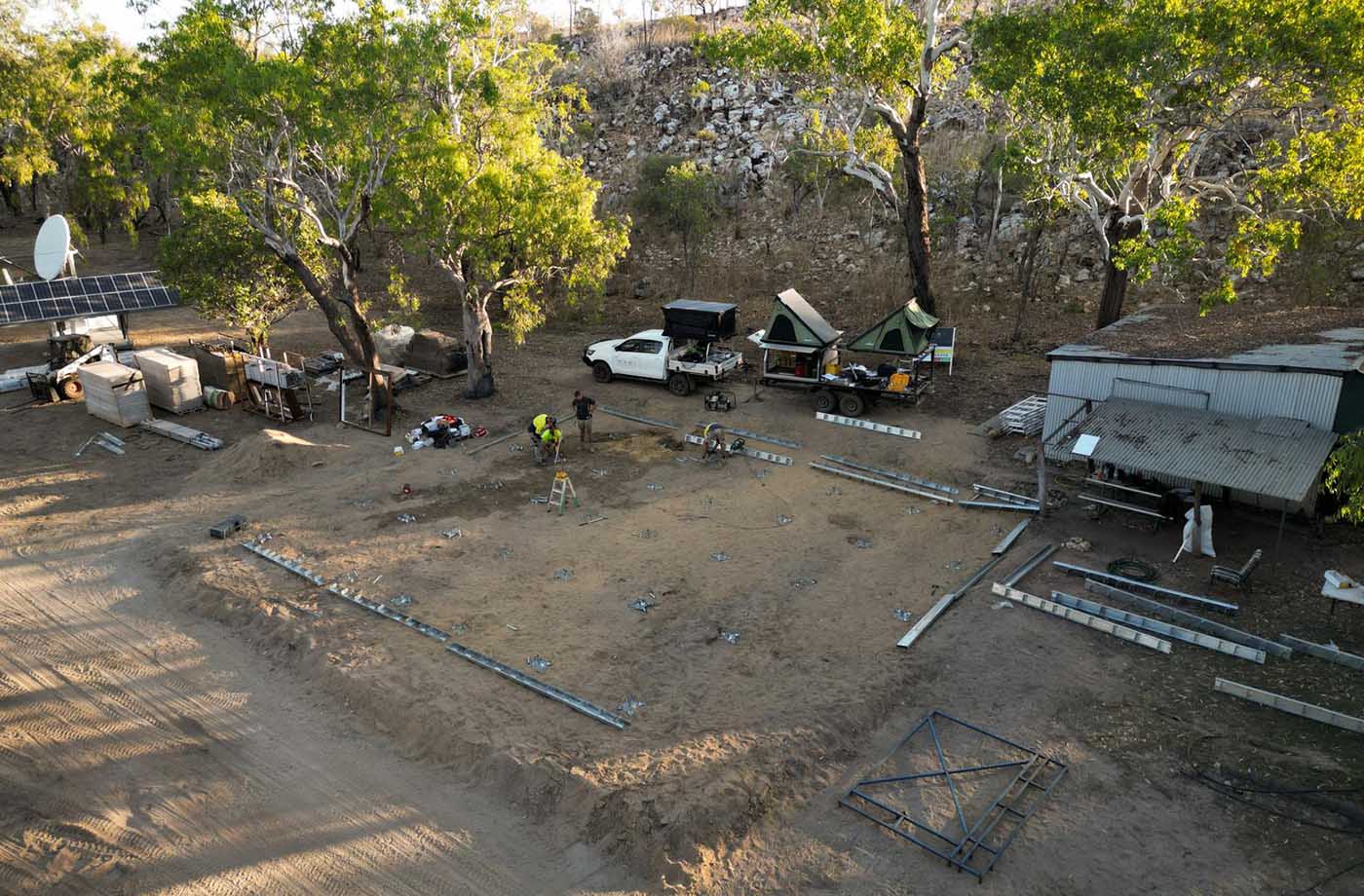

Ensure all materials are located within 5 meters of the individual sites.
Provide power within 30 meters of the site or arrange for an on-site generator.
If required, please supply temporary fencing for safety.
Arrange appropriate accommodation and 3 meals a day for all construction workers within 10kms of site.

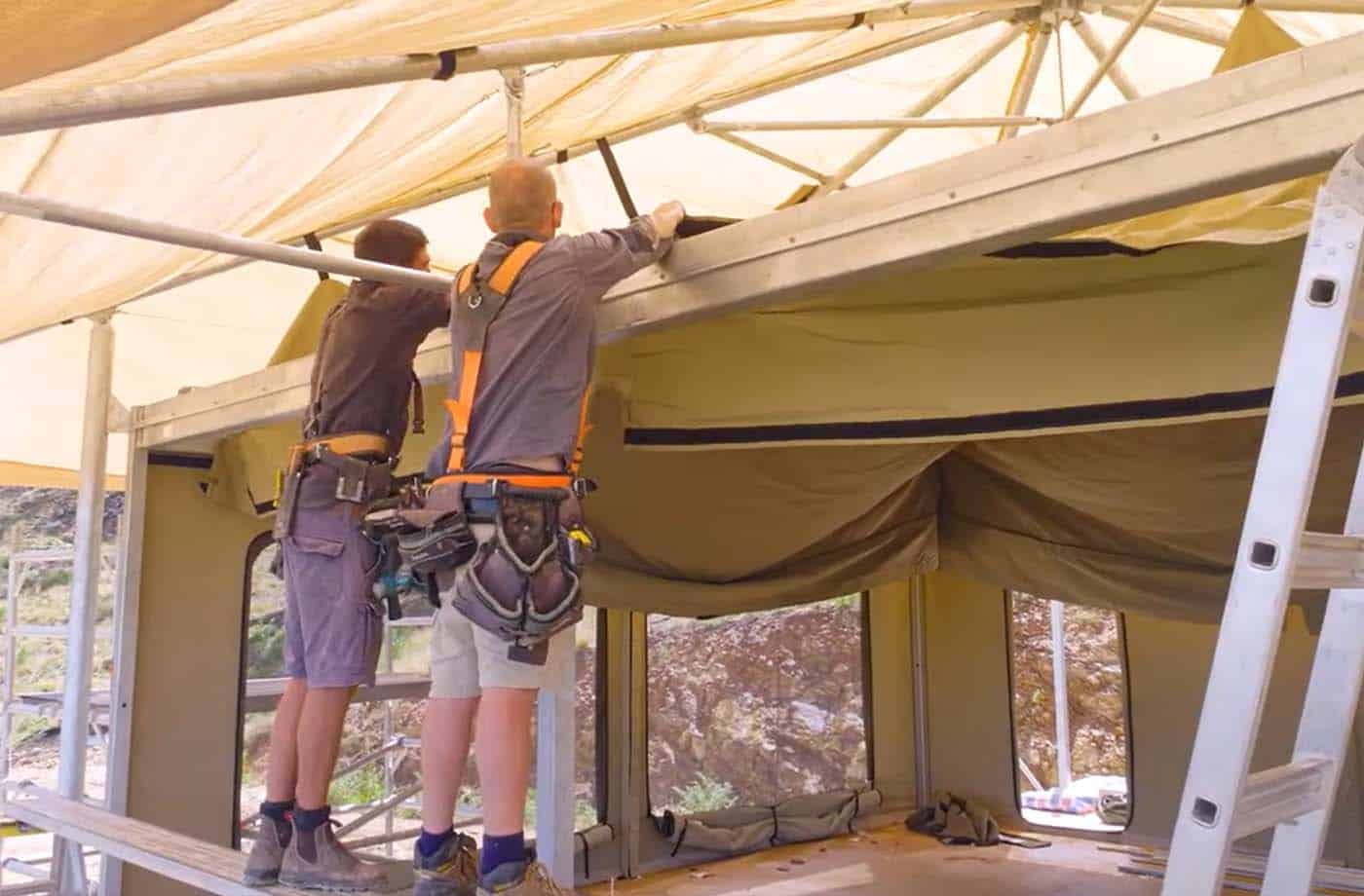

We’ll go over the project’s installation drawings with your preferred builder, confirm delivery schedules, and chat about site access and safety protocols. Making sure everything’s set for a smooth and successful install!
Prepare the site by clearing a 1m perimeter around the floor plan footprint. This ensures a clean and accessible space, ready for the next phase of the project.
We’d love for our clients to review the General Arrangement (GA) drawings and Bill of Materials (BOM) to make sure we’ve got all the pieces in place. It’s just a quick check to ensure everything’s ready for a smooth installation!

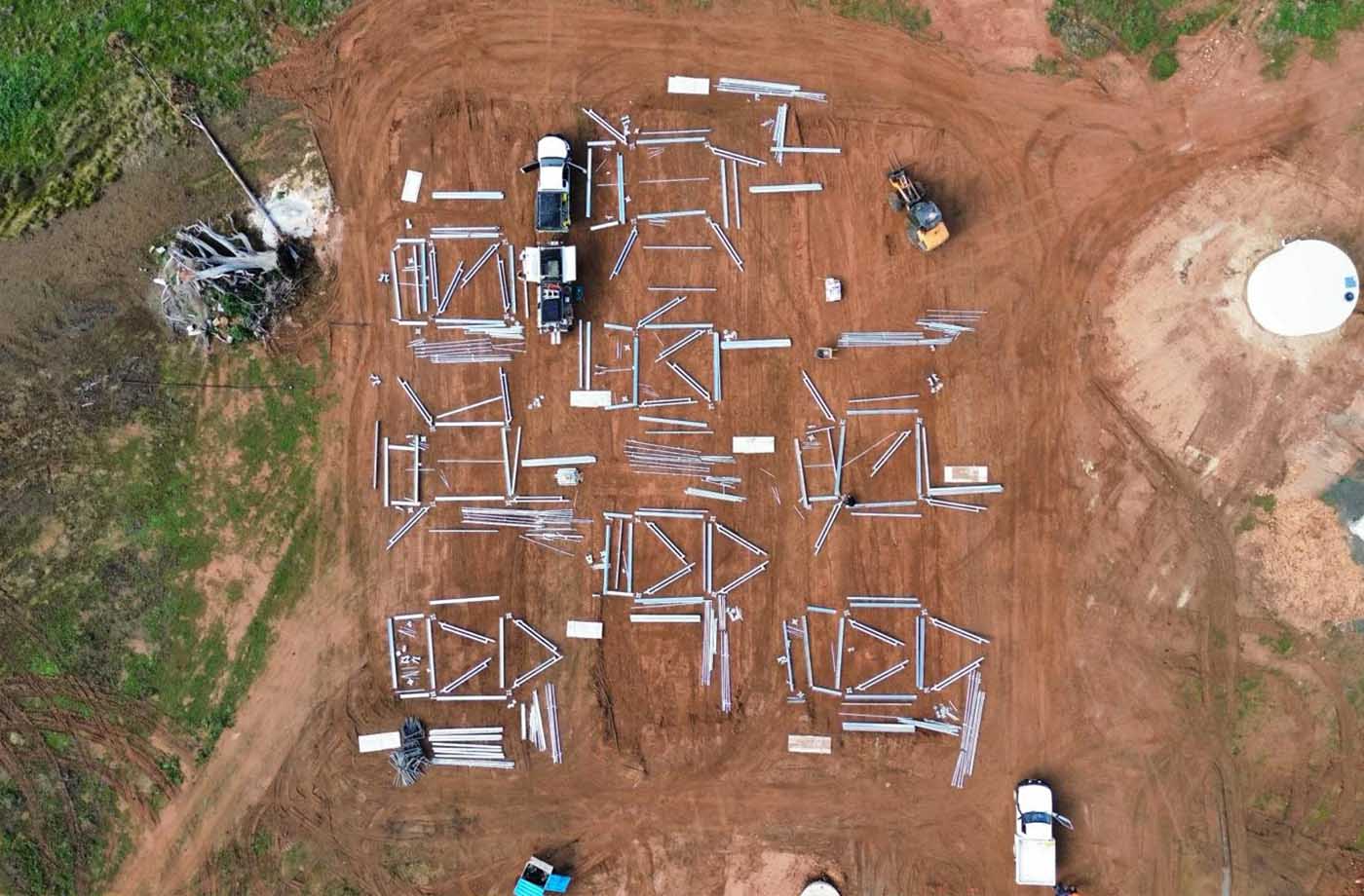

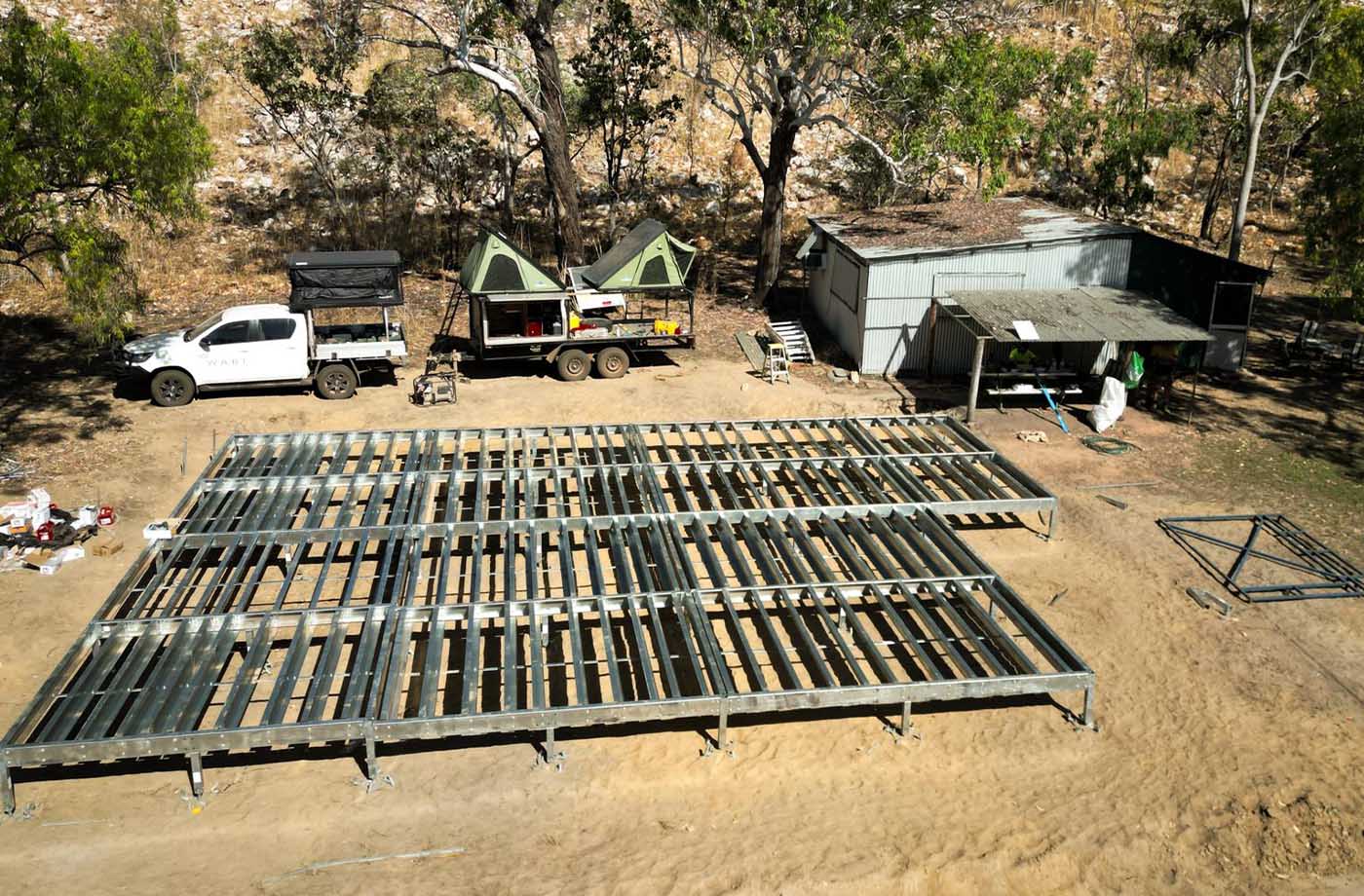

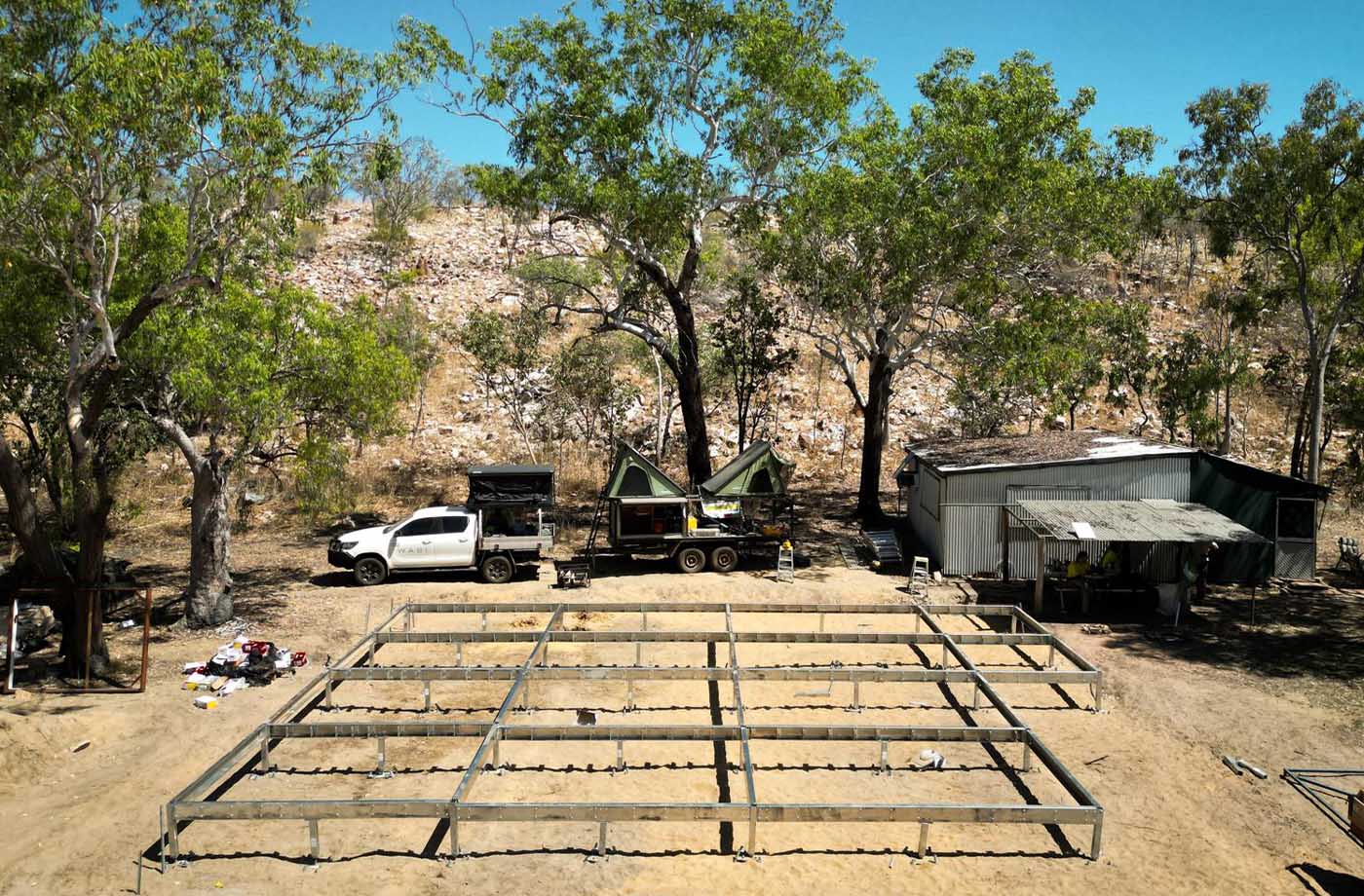

Make sure all materials are neatly positioned within 5m of their respective sites. All steel should be close by and easy to grab to ensure a fast and smooth build.
If you would like to purchase these tools directly though Eco Structures please reach out to your Sales Agent. Please click here to find the tools list
Clear the Site: Remove any obstructions and debris from the area.
Take Photos: Snap clear pictures of the area and materials within 5 meters and send them to the Eco Structures team.
Check Tools: Review the tool list. If you’re missing any tools, inform the team so our installers can bring them.
Set Installation Date: Once we have the photos and tool list, we’ll schedule the installation date.
Before the construction team arrives, you have three options for setting out your tent:

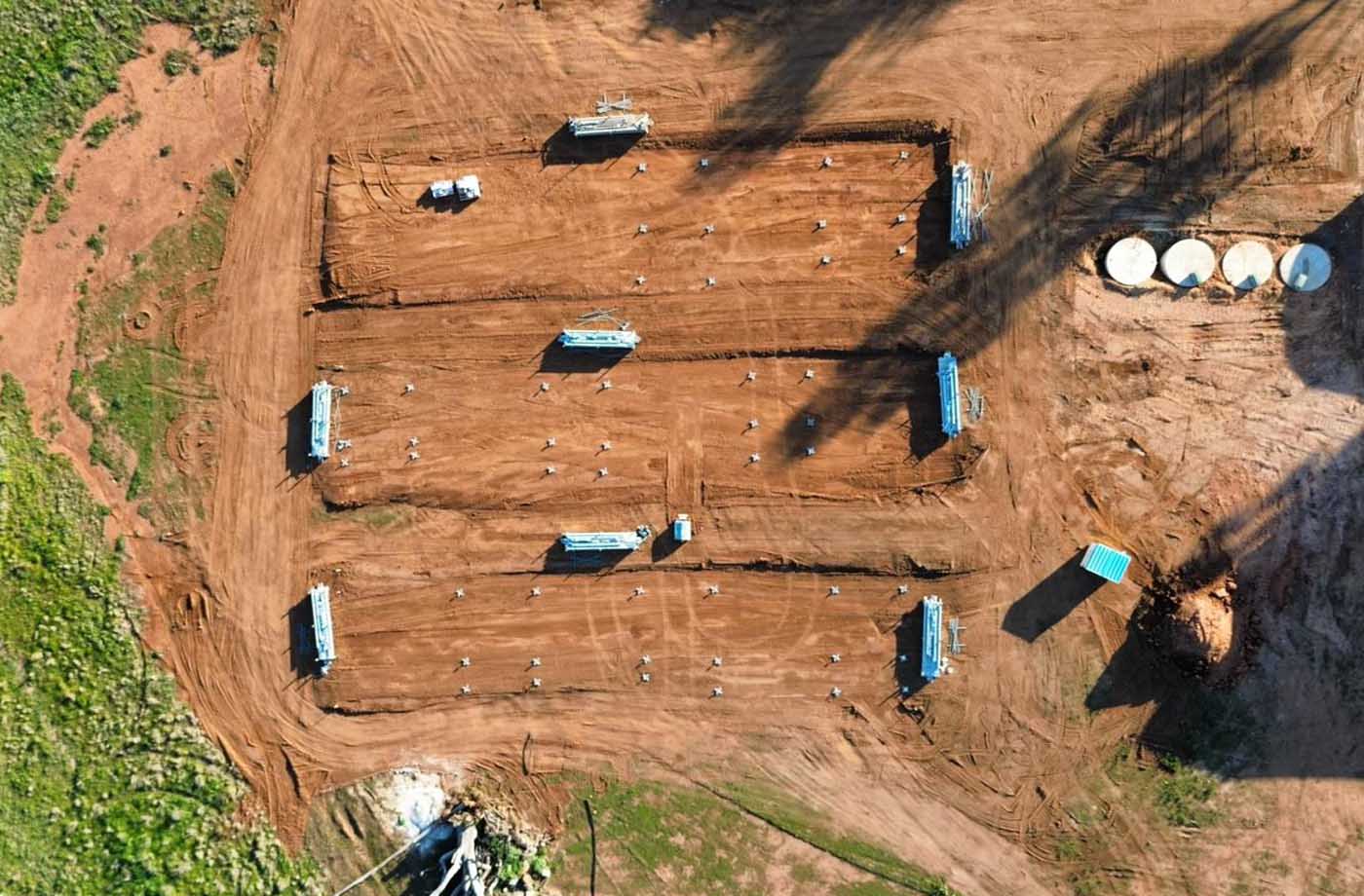

Standard Set Out Practices: Use a string line to establish the correct position.
Surveyor Assistance: Provide your original masterplan and our Eco Anchor Layout (GA Drawing) to your surveyors. They will use this information to mark the exact spot with pegs.

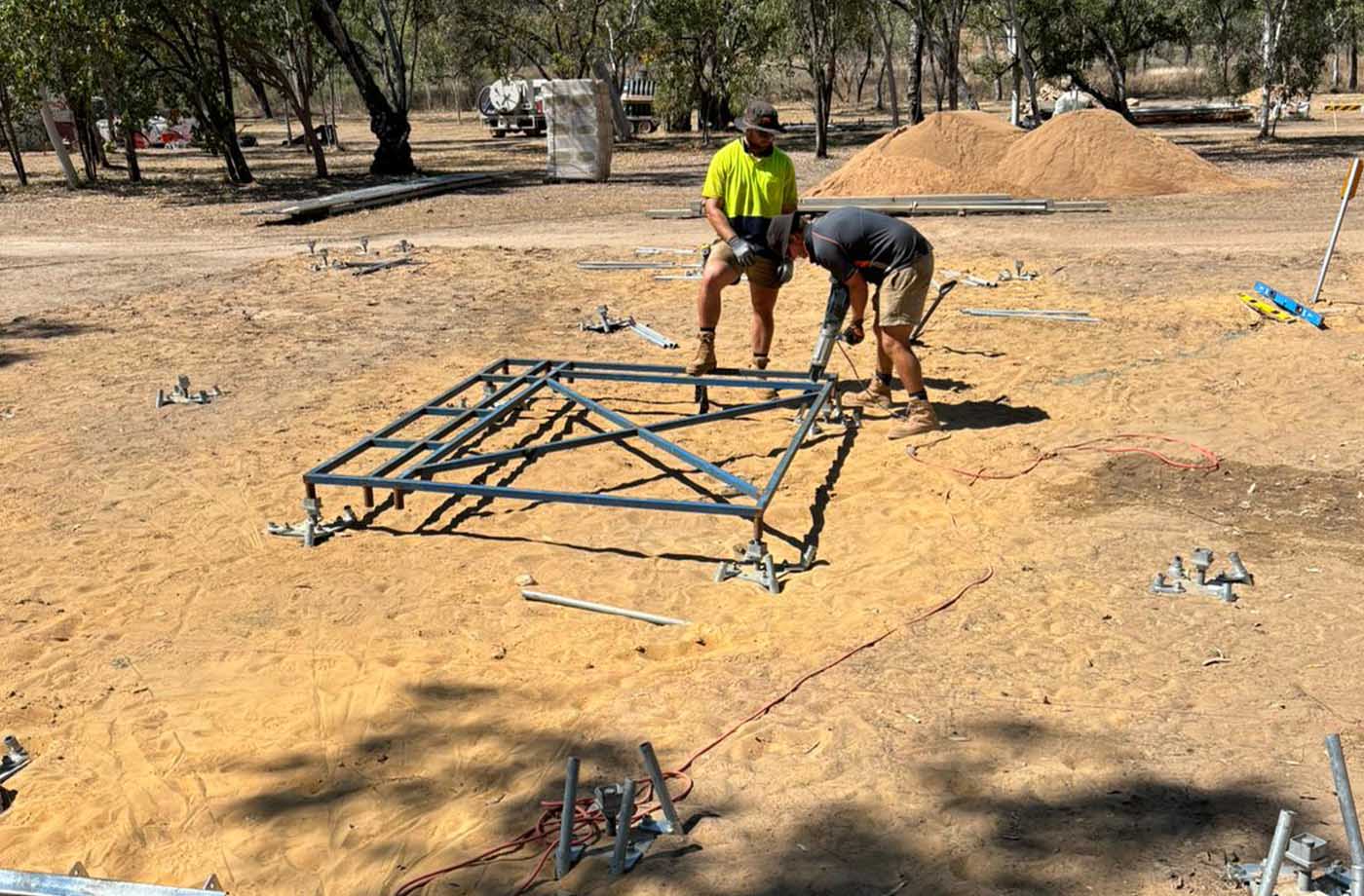

JIG Frame: For large unit orders, purchase a JIG frame through Eco Structures. This option helps ensure that your cabin's footing layout remains square and accurate.

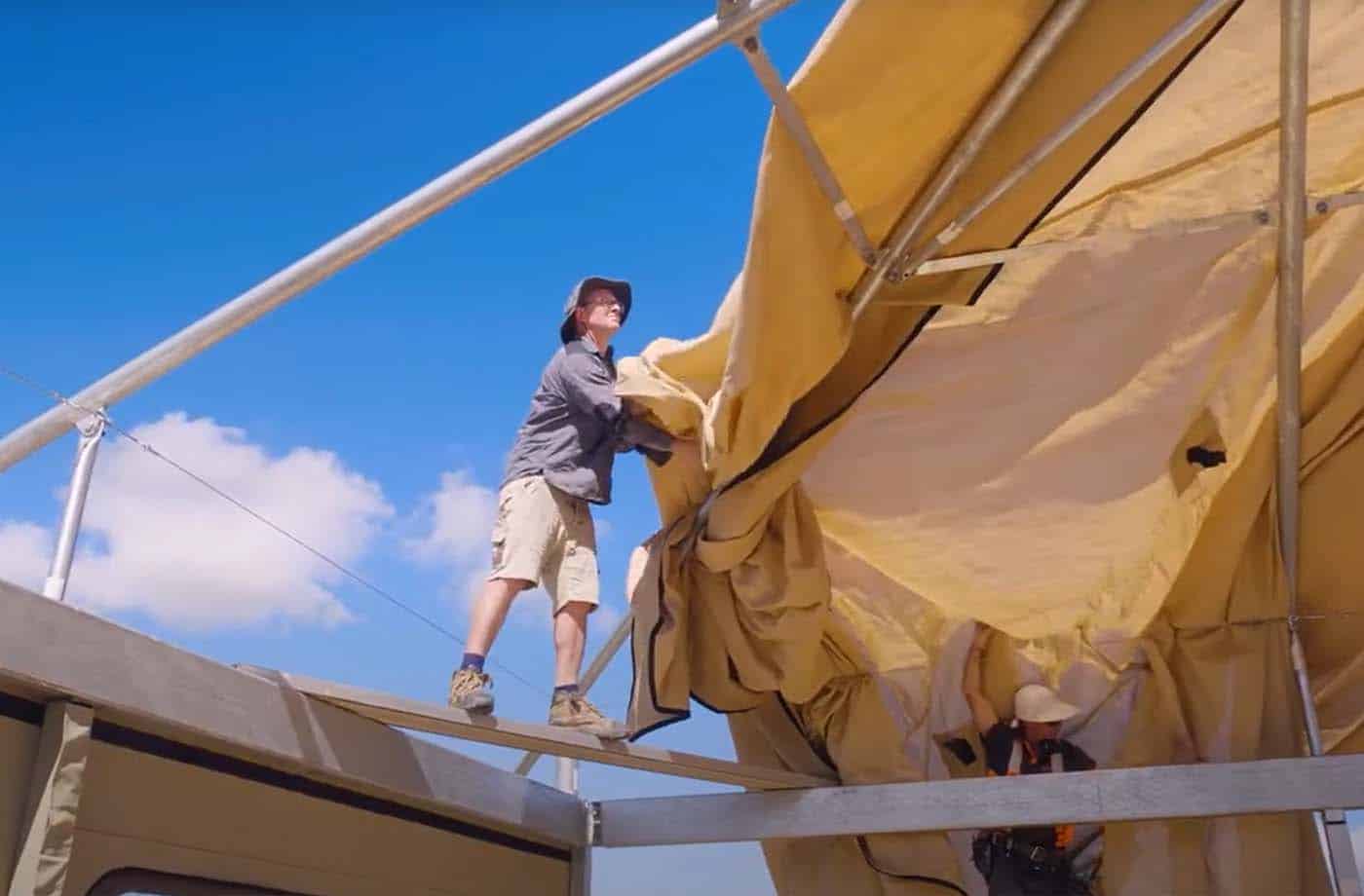

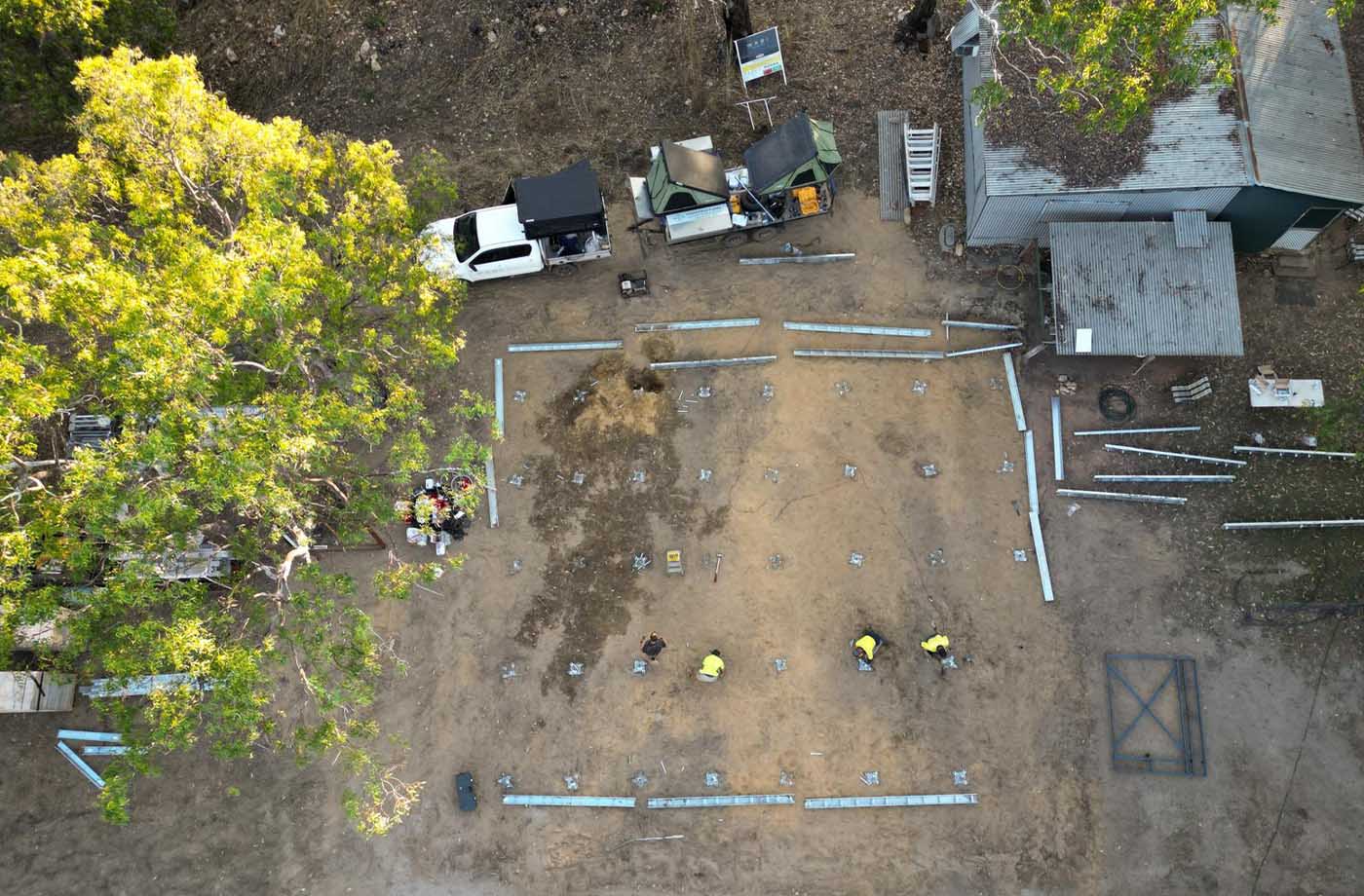

Based on your original order and geo tech report, you'll know whether to use eco anchors or concrete footings. For eco anchors, check out our video guide—it's as simple as driving 4 x 1m rods into the ground with a pneumatic hammer. If you're going with concrete footings, just ask your external contractor for their process.

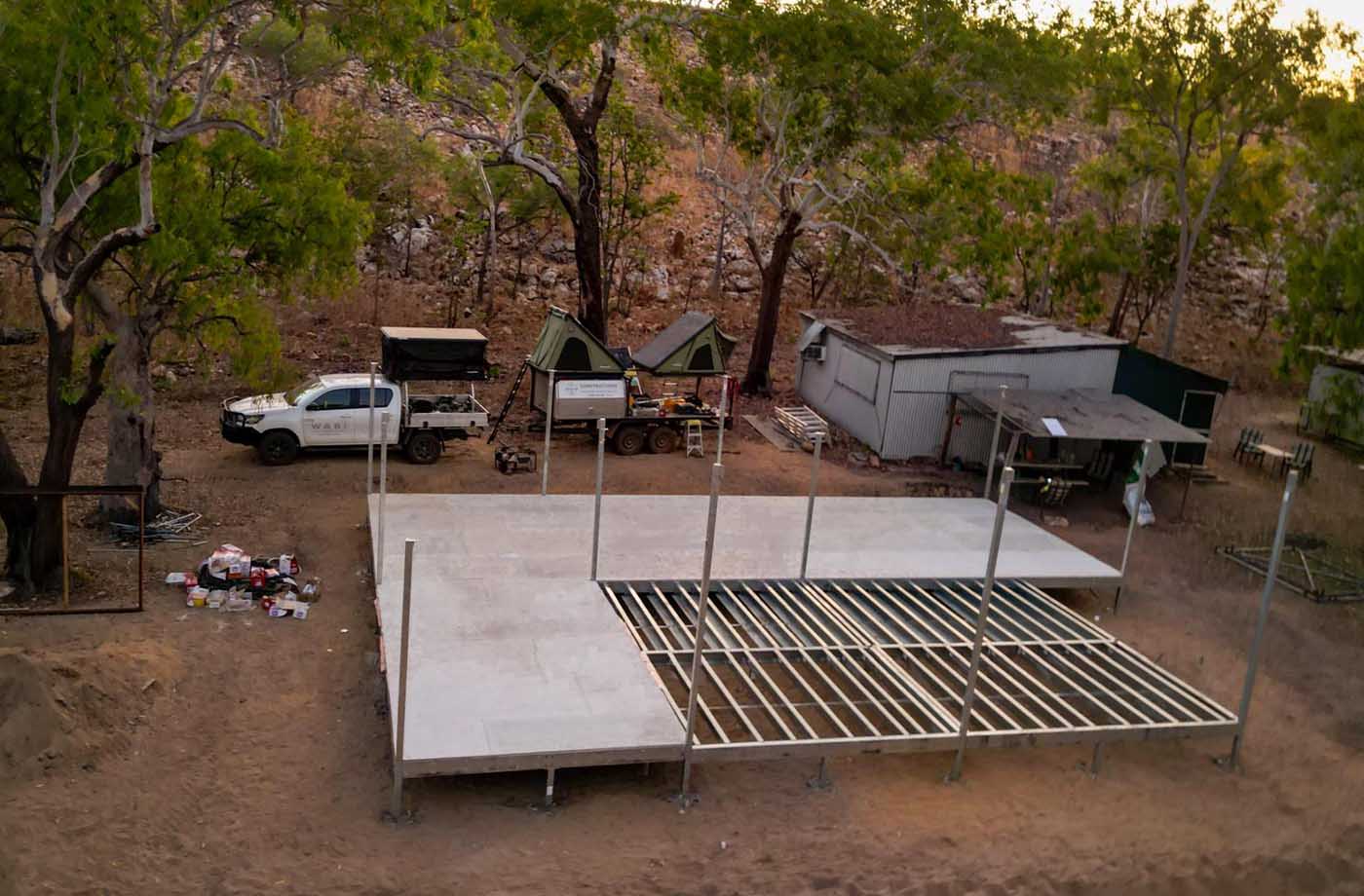

Our tents sit 600mm above the ground, so you can do civil work either before or after installation, depending on your schedule. If using eco anchors, just avoid large trenches within a 1m² area around each anchor.
If you would like to purchase these tools directly though Eco Structures please reach out to your Sales Agent.
Man Hours Guide
Disclaimer:
The total hours for the installation of each tent/structure are accurate providing the following listed conditions are met throughout the installation process. If any of the listed conditions are not met, extra time must be allowed for the installation.
3.0m x 3.0m Eco Tent | 2 Skilled installers, 1 Semi-skilled labourer 1.5 days (10 hour working day) 45 man hours |
4.2m x 4.2m Eco Tent | 2 Skilled installers, 1 Semi-skilled labourer 2 days (10 hour working day) 60 man hours |
5.0m x 5.0m Eco Tent | 2 Skilled installers, 1 Semi-skilled labourer, telehandler 3 days (10 hour working day) 90 man hours |
6.3m 6.3m Eco Tent | 2 Skilled installers, 1 Semi-skilled labourer, telehandler 3.5 days (10 hour working day) 105 man hours |
Enclosure 3.0m x 1.8m (including subfloor) | 2 Skilled installers 12 man hours |
Enclosure 4.2m x 1.8m (including subfloor) | 2 Skilled installers 15 man hours |
Enclosure 5.0m x 1.8m (including subfloor) | 2 Skilled installers 18 man hours |
Enclosure 6.3m x 1.8m (including subfloor) | 2 Skilled installers 1 day (10 hour working day) 20 man hours |

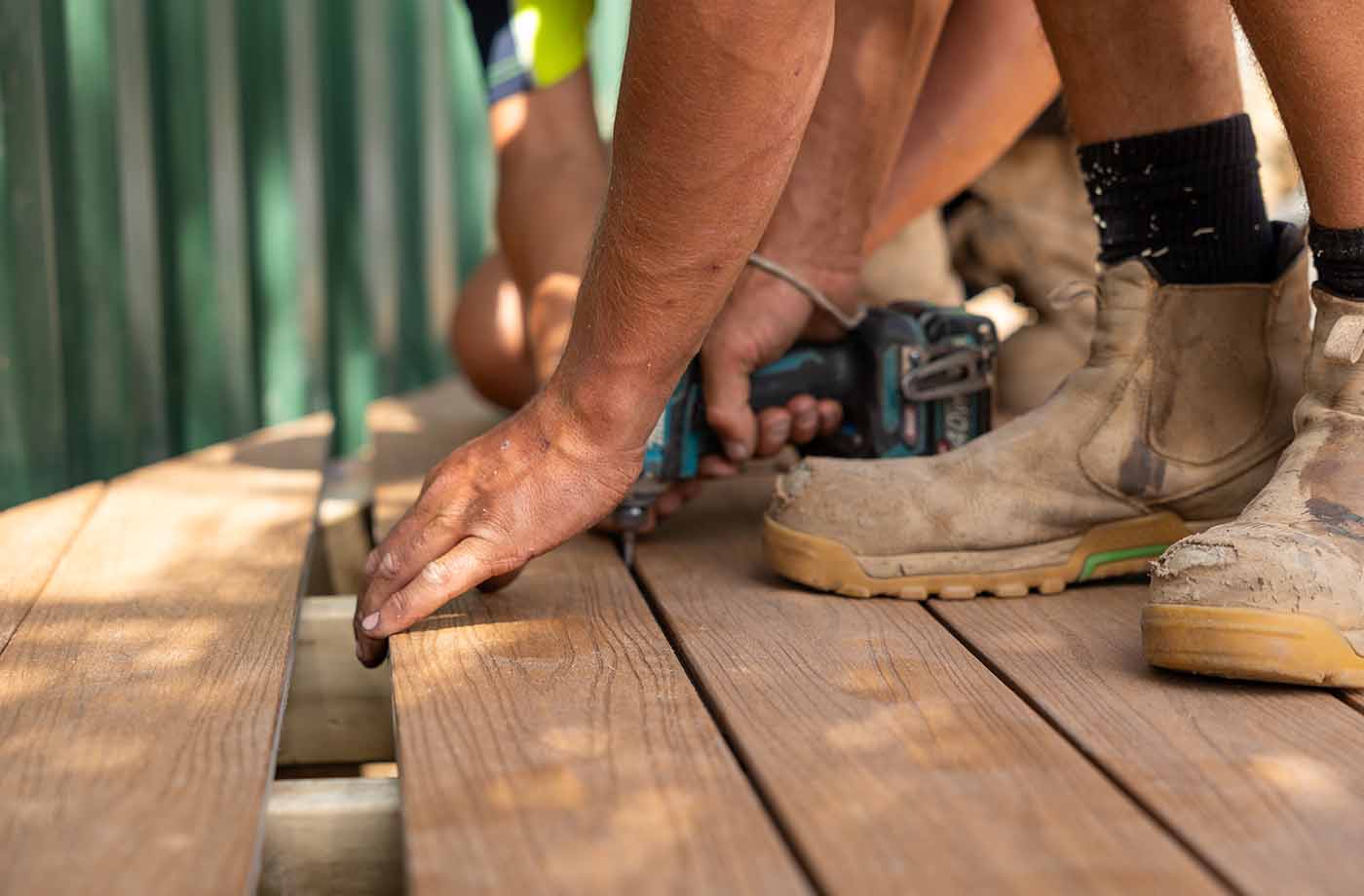

Deck 3.0m x 1.8m | 2 Skilled installers 8 man hours |
Deck 4.2m x 1.8m | 2 Skilled installers 10 man hours |
Deck 5.0m x 1.8m | 2 Skilled installers 13 man hours |
Deck 6.3m x 1.8m | 2 Skilled installers 1 day (10 hour working day) 15 man hours |
P1, P4 or PD-UAT | 2 Skilled installers 10 man hours |
Gazebo 3.0m x 3.0m | 2 Skilled installers 1 Semi-skilled laborer 27 man hours |
Gazebo 4.2m x 4.2m | 2 Skilled installers 1 Semi-skilled laborer 36 man hours |
Gazebo 5.0m x 5.0m | 2 Skilled installers 1 Semi-skilled laborer 54 man hours |
Gazebo 6.3m x 6.3m | 2 Skilled installers 1 Semi-skilled laborer 60 man hours |
